South Cypress Side Channel Restoration
 Daily Log Entry:
November 2, 2020

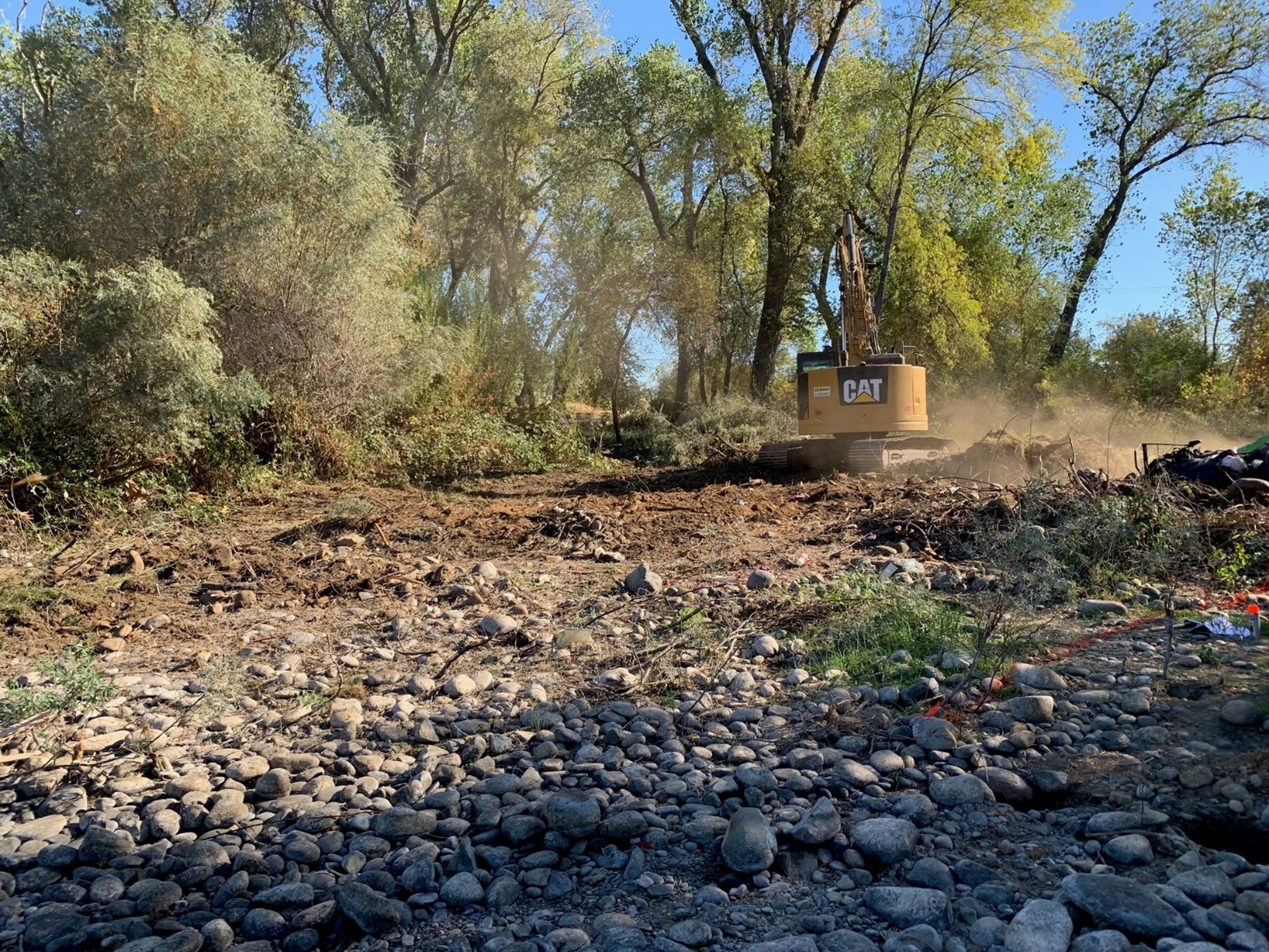

After a pre-construction meeting and environmental training, a job site walk through with the construction crew was carried out.
We then assisted the River Partners with tree removal and brush clearing. |  Daily Log Entry:
November 3, 2020
We conducted a morning briefing and attended cultural training with the Wintu Tribe.
Excavation in the north section of side channel has been started and a berm was constructed to keep fish out of the work area after the U.S. Fish and Wildlife used netting to clear the fish from south portion of project.
We began rock screening.
NOTE: The material that is being screened is very wet. |  Daily Log Entry:
November 4, 2020
We held our morning briefing and safety meeting discussing one-way travel, branch removal and watching for unauthorized people on the work site.
Temporarily shut down the rock screen for maintenance: tightened the belt.
We excavated and hauled material from north channel to the screening plant and removed vegetation from the southern end of project.
The work crew removed an old concrete weir structure. |
---|
 Daily Log Entry:
November 6, 2020
After the morning briefing and safety discussion we continued the excavation of the channel and material screening.
We had a successful first attempt at injecting the spawning gravel injection.
We began to relocate screen plant and stockpile area to a private landowner’s property north of the staging area. We also moved the sorted material to the new location. |  Daily Log Entry:
November 10, 2020
At the morning briefing we talked about Covid-19 guidelines and safety procedures along with jobsite safety and awareness.
We continued the side channel excavation and screening of material for the spawning gravel.
Jon Hannon from the Bureau of Reclamation directed the crew on the proper location and installation of the wood materials for habitat restoration. |  Daily Log Entry:
November 13, 2020
We had our morning briefing and talked about the decreased visibility and wet, possibly slick, conditions due to the rain.
After successfully injected 410.86 and 74.76 cu yds of spawning gravel the previous two days we continued excavation of southern end of the side channel.
Screening of material for spawning gravel continued. |
---|
 Daily Log Entry:
November 14, 2020
After our morning briefing and safety discussion we continued excavating the excess material from the side channel.
During the screening of the material a bone was found. The southern channel excavation was halted per Cultural Monitors.
Upon inspection the bone was determined to be from an animal so excavation and material screening resumed at 3:00. |  Daily Log Entry:
November 16, 2020
During our daily briefing and safety talk we discussed job site safety and communication.
We continued to excavate and stockpile the overburden material as well as excavate the channel and screen material for spawning gravel.
An interview and jobsite tour was given for the SacValley.org folks, Holly Dawley was interviewed. |  Daily Log Entry:
November 17, 2020
We continued to the cut channel grade from station 14+25 to 18+00, cut channel grade at station 21+75 and placed wood habitat.
Graded from station 24+50 to 26+00. This area will need to be regraded; the cut was a little high.
Continued to screen material and stockpile. |
---|
 Daily Log Entry:
November 19, 2020
Held the morning briefing and safety talk.
We regraded the channel from 24+50 – 26+00 and started channel grading from station 19+50 – 20+00
Continued screening material.
We successfully injected approximately 400 CY of spawning gravel into river. |  Daily Log Entry:
November 20, 2020
We conducted the morning briefing talking about mask protocols and job safety.
Continue channel excavation and material screening.
Continued the gravel injection. The turbidity levels began spiking so we changed injections to 2 or 3 times per day. |  Daily Log Entry:
November 23, 2020
The middle haul road was removed, and channel excavated.
The pinch point between the two ponds is currently being excavated.
The removal of overburden materials is ongoing and we are continuing to inject spawning gravel. |
---|
 Daily Log Entry:
November 25, 2020
Discussed job safety at the morning briefing.
We continued with the channel excavation. The material screening is ongoing and successful gravel injection is in progress.
Meeting scheduled with job site consultant Terry Hanson about access route on to jobsite.
All crew personnel will return on Monday 11/30/2020 after the Thanksgiving Holiday. |  Daily Log Entry:
November 30, 2020
We had our morning briefing and conducted a job safety briefing.
Completed the channel excavation at the culvert crossing.
Completed wood habitat placement.
Continued to screen material and inject gravel into main river channel. |  Daily Log Entry:
December 4, 2020
Held morning briefing and safety discussion.
We continue the haul route rehab and completed the removal of northern dam.
Continue grading spawning gravel.
Conducted the 10:00AM punch list walkthrough and received the new specifications for haul route road rehab. |
---|
 Daily Log Entry:
December 7, 2020
After our morning meeting we began cleanup an top dressing the haul route.
Hauled loader buckets of fines material for Terry Hanson.
Finished final grading of spawning gravel and removed the containment berm.
Continued to add wood habitat material to channel per John Hannon. |
---|
